Featured Paper

The Symbiotic Relationship Between the Programme Management Office (PMO) and Project Control

Introduction: Defining the Strategic Partnership

In the contemporary landscape of complex project delivery, the success of an organisation is no longer determined by the isolated efforts of individuals but by the robust integration of management structures and analytical disciplines. At the heart of this integration lies the critical relationship between the Programme Management Office (PMO) and Project Control (PC). While these two entities are often viewed as distinct departments, they are inextricably linked in a symbiotic relationship that defines the organisational capacity for success.

A PMO is defined as a management structure that standardises project-related governance processes and facilitates the sharing of resources, methodologies, tools, and techniques. Its core purpose is to provide support to all parties within the organisation and enable informed decision-making by providing a "single source of truth" regarding performance. However, a PMO cannot function as an empty shell of governance; it requires the data-driven disciplines of Project Control to provide substance to its oversight. Project Control is the set of disciplines focused on implementing methods, resources, and activities necessary to support the team to accomplish project objectives and subsequently monitoring time, cost, and quality.

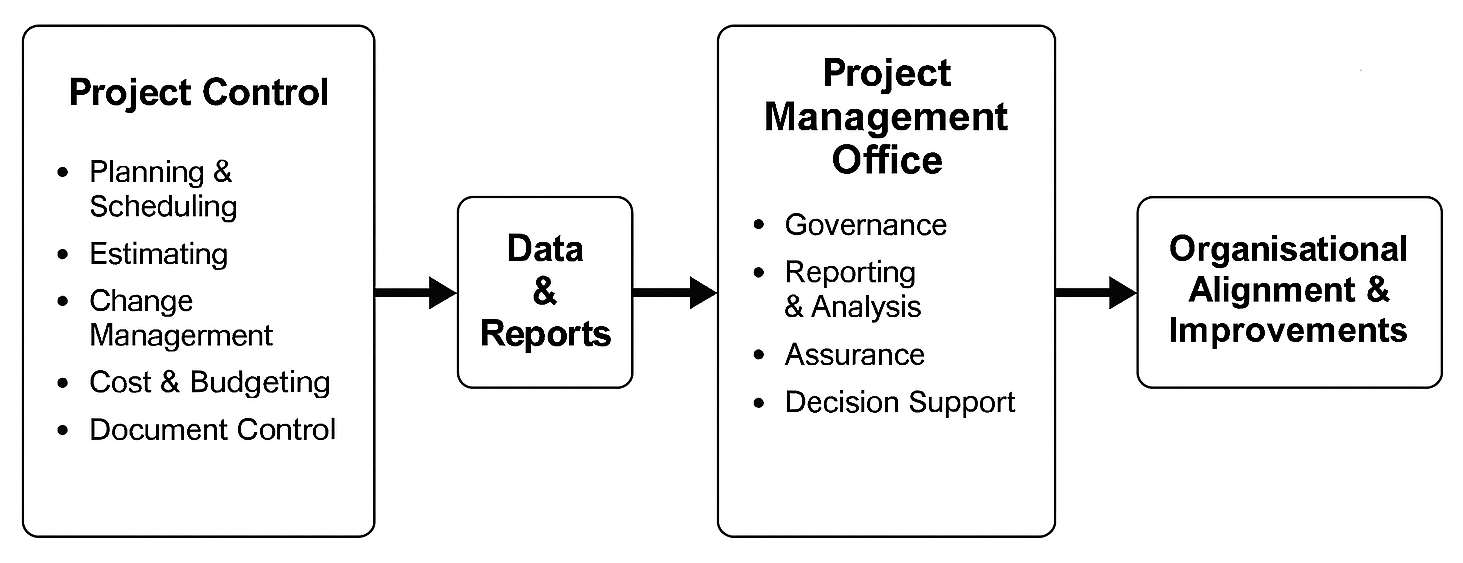

Figure 1 below provides a high-level view of the relationship flow between PMO and project control.

Figure 1. The PMO – Project Control relationship flow.
Figure 1. The PMO – Project Control relationship flow.

The author of this article explores how these two functions interface to provide enhanced predictability of delivery, manage multi-project complexities, and ensure that every project serves as an engine for the organisation's broader strategic goals.

The Foundations: Function, Purpose, and Taxonomy

The Evolving Definition of the PMO

The PMO has evolved significantly from its origins in the mid-20th century, where it primarily assisted in monitoring and controlling large-scale military and aerospace development projects. Today, it is a well-established concept spanning diverse industries, including IT, construction, manufacturing, and energy. The PMO also serves as a Centre of Excellence (CoE) and a knowledge management hub, promoting project management maturity and standardisation.

The form of a PMO depends entirely on the organisation's requirements. However, the APM (2019) identifies three types, which are:

Embedded PMO
Where the majority of functions are delivered under the control of the project or programme manager.
Central PMO
Where functions sit outside the delivery teams, providing a service to multiple projects across the enterprise.
Hub-and-Spoke PMO
A hybrid model with a central enterprise PMO linked to satellite PMOs within individual projects or regions.

The PMI (2017) identifies three forms:

  • Supporting: where the PMO consults and provides information.
  • Controlling: where the PMO requires compliance, adherence to policies and procedures – templates, metrics, etc., and
  • Directive: it demands a high level of control, providing professional services, including the PM for each project.

The Project Control Engine

Project Control provides the "underpinning" for the PMO and is defined as 'The application of project, programme and portfolio management processes within a framework of project management governance to enable an organisation to do the right projects and to do them right' (APM, 2006). It comprises processes and techniques used to support the PM and the teams to manage scope, cost, time, risk, resources, and performance, using structured approaches such as scheduling, estimating, risk management, cost control, and reporting. As defined in the APM (2015), these processes ensure clarity, consistency, and predictability through quantification, monitoring, and analysis of project performance.

It is not a single activity but a suite of key disciplines that perform these processes, which roll up into the PMO framework to provide a comprehensive view of the project environment. Some of these disciplines are listed below:

  • 01 Planning
  • 02 Scheduling
  • 03 Estimating
  • 04 Risk Management
  • 05 Cost and Budget Management
  • 06 Change Control
  • 07 Resource Management
  • 08 Progress Measurement
  • 09 Performance Reporting
  • 10 Document Control

Together, these disciplines, as well as the documentation that supports these processes (discussed in more detail below), ensure that the PMO is supported to focus on the deliverable, managing the complex interconnections between people, governance and assurance, etc.

Functional Interdependencies

The PMO and Project Control collaborate across key processes, as shown in the table below.

PMO Area Project Control Contribution
Portfolio Governance Forecasting, budgeting, risk exposure mapping
Assurance Independent performance data, earned value assessments
Risk & Change Management Quantification, impact modelling, scenario analysis
Resource Planning Resource-loaded schedules, utilisation reporting
Knowledge Management & Centre of Excellence (CoE) Continuous improvement data, lessons learned

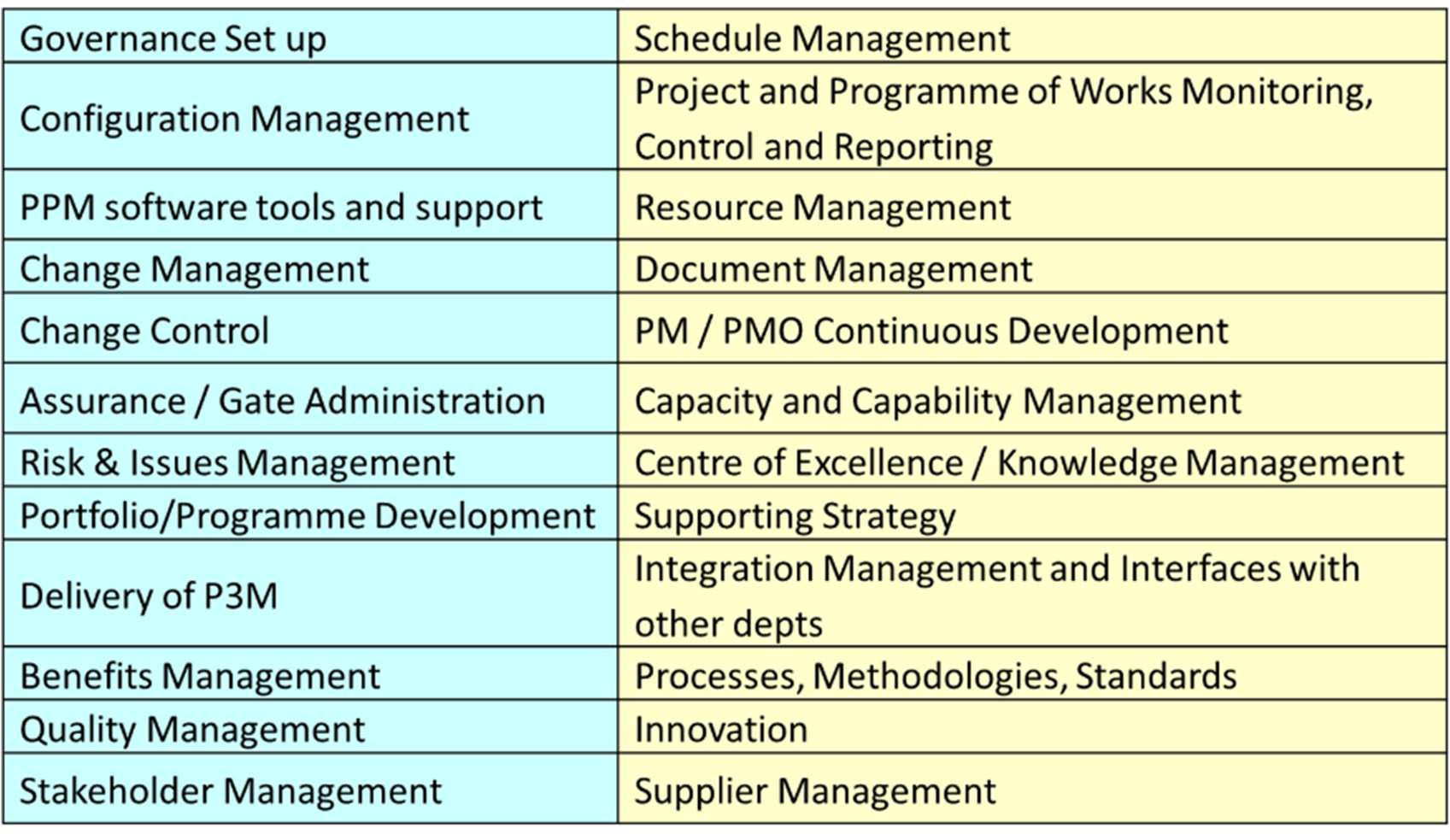

Also, Figure 2 below provides a summarised view of the possible PMO Domain, where again a large number of the deliverables are covered by the Project Control processes.

Figure 2. The possible PMO domain.
Figure 2. The possible PMO domain.

Theoretical Frameworks of Integration

The PMO Hierarchy of Needs

Derived from Maslow's theory of human motivation, the PMO Hierarchy of Needs (Arnaz-Pemberton) posits that a PMO evolves through five distinct stages as its value to the organisation increases. These are (from the lowest to the highest):

  1. 1
    Business Problem or Opportunity: The foundational level where the need for monitoring and control is first identified.
  2. 2
    Value Perception: Achieved through active sponsorship and championing at the senior management level.
  3. 3
    Partnership: The PMO becomes a respected business partner involved in strategy development.
  4. 4
    Maturity: A stage of continuous improvement following a mapped-out journey.
  5. 5
    Innovation: Realising full potential through targeted transformation and industry recognition.

Project Control acts as the 'physiological' base of this hierarchy. Without accurate data on cost and schedule, a PMO cannot satisfy the foundational need and therefore cannot progress toward "Partnership" or "Innovation".

Centralisation by Decentralising

A core principle of a correctly established PMO is providing 'centralisation by decentralising'. In this theoretical model proposed by the author, the PMO centralises the governance, methodology, and standard structures, while decentralising the actual execution of control activities to the project teams. This relationship allows the PMO to maintain the big picture while ensuring project-level agility and accountability.

Human Interfaces and the Soft Relationship

While Project Control focuses on hard processes and data, the PMO manages, in the majority, the soft interfaces between people.

The Role of the PMO Champion: Establishing a PMO is a major cultural change that often faces resistance. PMO Champions are individuals who roll out requirements to their specific departments and act as a bridge between the PMO management and the project teams.

Supporting Project Managers (PMs): PMs are often under high stress and may perceive PMO processes as bureaucratic overhead. A well-performing PMO supports PMs through a CoE by taking over administrative burdens, allowing the PM and the teams to focus on team leadership and delivery. The relationship is defined by a RACI matrix, which clarifies who is Responsible and Accountable for each control process, reducing conflict.

Structural Integration: The 'Common Language'

Standard Project Management Structures

The most critical link between the PMO and Project Control, as well as all the parties involved in delivering the Project Programme or Portfolio, is the establishment and maintenance of standard project management structures. These structures serve as the 'glue' that allows data to be aggregated across a diverse portfolio. Key structures include:

  • Work Breakdown Structure (WBS)
  • Cost Breakdown Structure (CBS)
  • Organisational Breakdown Structure (OBS)
  • Project Breakdown Structure (PBS)
  • Risk Breakdown Structure (RBS)
  • Responsibility Assignment Matrix (RAM), which is the product of combinig WBS and OBS

The integration is visualised through the Asset Hierarchy, where granular project-level structures roll up into Regional Plans, then into Directorate levels, and finally into the overall Asset Management Plan managed by the PMO. These structures are the core elements for rolling up data by the PMO to generate "viz-boards" for directors that show real-time performance without requiring manual data manipulation.

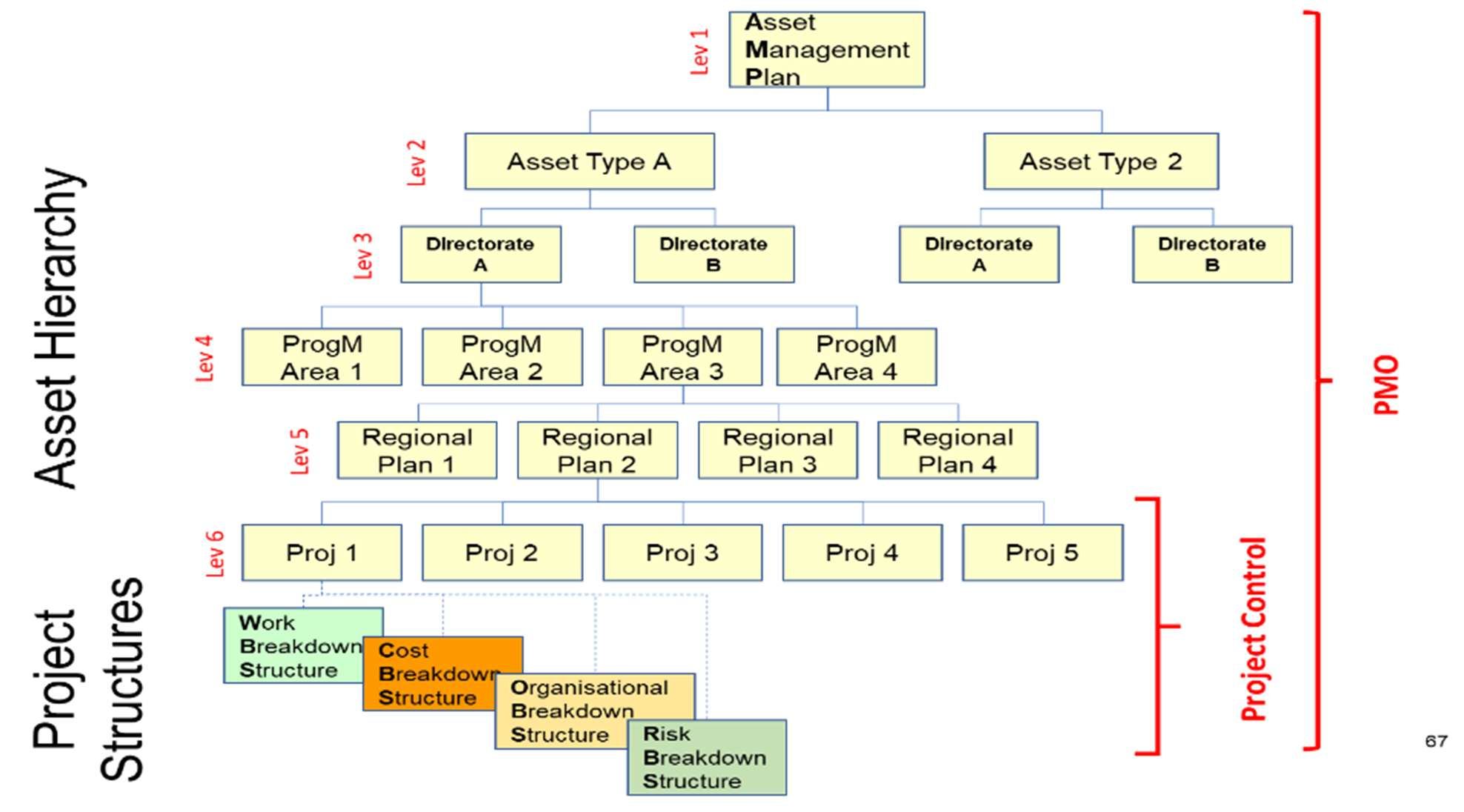

Figure 3 below gives an example of the integration of the Asset Hierarchy with the standard project management structures.

Figure 3. Integration of standard project management structures.
Figure 3. Integration of standard project management structures.

Linking Time and Cost

The PMO mandates an integrated approach where the scheduling tool (e.g., P6, MS Project, etc.) becomes central to monitoring. By ensuring that schedules are logically linked with a critical path and loaded with resource and cost data, Project Control provides the PMO with the ability to calculate expenditure profiles, forecast long-term resource bottlenecks, and provide data to other departments – finance, supply chain, HR, etc. – as and when required.

Procedural Governance: The Handbooks

The relationship is formalised through two distinct but complementary documents: the PMO Handbook and the Project Control Handbook (PCH).

  • The PMO Handbook: This document outlines the vision, mission, and strategic interfaces of the department. It describes the "Why" and "What" of the PMO, including governance boards and compliance requirements.
  • The Project Control Plan (PCP): Developed alongside the Project Management Plan (PMP), the PCP is the "How-to" guide for delivery teams. It defines specific processes for baseline management, progress collection, change control (integrating both cost tools and schedules), standard structures, reporting cut-off dates, etc.

By mandating that every project follows a standardised PCH, the PMO ensures that Project Control is performed consistently across the enterprise, reducing duplication of effort and improving confidence in data.

The Information Chain: From Data to Decisions

The PMO deals with the various agents in an organisation and how they perceive information. To avoid behavioural selective acquisition, where stakeholders only accept data that fits their existing bias, Project Control and the PMO must establish rigorous checks which will allow the management of 'filtering' that occurs in non-linear information flow.

Project Control should act as the "single source of truth", providing validated data for portfolio boards, programme managers, and executives. Figure 4 presents graphically how data (and in most cases reporting) flows through project teams (PC) to PMO and becomes information, via the various project control processes, which then enables decision-making.

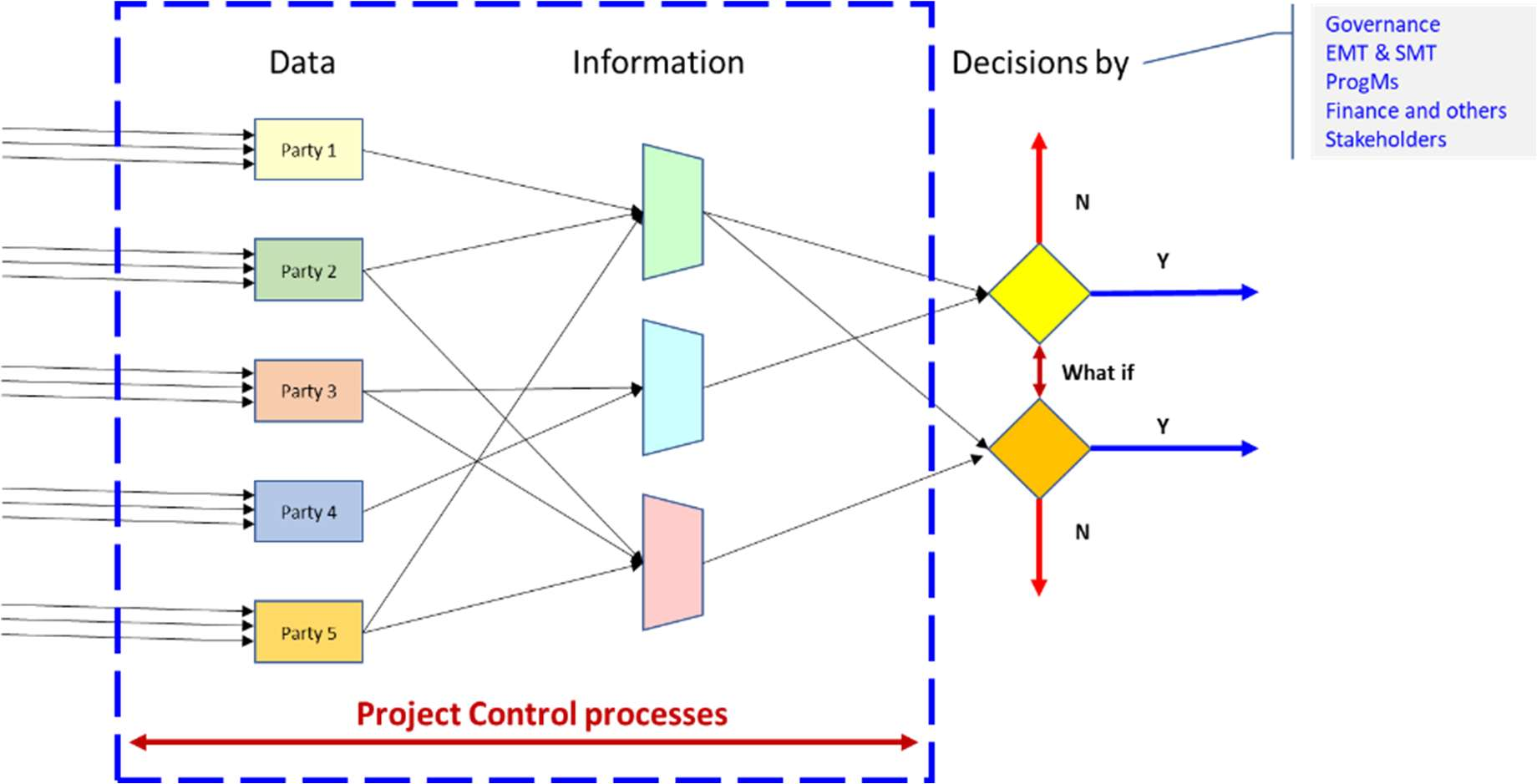

Figure 4. Data flow which becomes information for decision-making.
Figure 4. Data flow which becomes information for decision-making.

Regulating the Boundaries

A major cause of project issues is the lack of coordination between requests from various parties. The PMO's role is to regulate the boundaries and minimise influencing factors that lead to information manipulation. Reporting is not merely a contractual obligation; it is built on the "5 Ts":

Trust
Truth
Tolerance
Thoughtfulness
not going over the top

Governance and Assurance

The relationship between the PMO and Project Control is central to the concept of Assurance, the independent process that provides confidence to the board that a project is on track to deliver its intended benefits.

The Three Lines of Defence Model

To ensure robust assurance and governance, the relationship, as described by APM (2004 & 2019), follows a three-tiered approach:

  • First Line: Management controls performed by Project Control teams (e.g., progress monitoring, budget tracking).
  • Second Line: Compliance monitoring and quality assurance performed by the PMO to verify that the first line is functioning correctly.
  • Third Line: Independent reviews and audits conducted by external agents or high-level boards.

PC is crucial to at least the first two lines of defence as it provides not only the data but also the robust processes which will provide the confidence to the PMO and the higher level of organisational structures.

Supporting the Governance Board

The board has overall responsibility for governance, but it relies on the PMO to provide relevant and realistic information. Project Control data allows the board to:

  • Make Go/No-Go decisions at project gateways.
  • Approve major changes based on integrated performance metrics.
  • Ensure statutory obligations and ethical standards are met.

Strategic Adjustment

Responsibility for strategy lies with leadership, but the PMO provides insight into what is possible to achieve. By knowing the organisation's true capacity, derived from Project Control resource tracking, the PMO advises on outsourcing or contract workers to expand delivery capability rapidly.

A Sample Executive Programme Office (EPO) Structure

At a higher level and in support of a more strategic role, it is possible for an international organisation to establish an EPO.

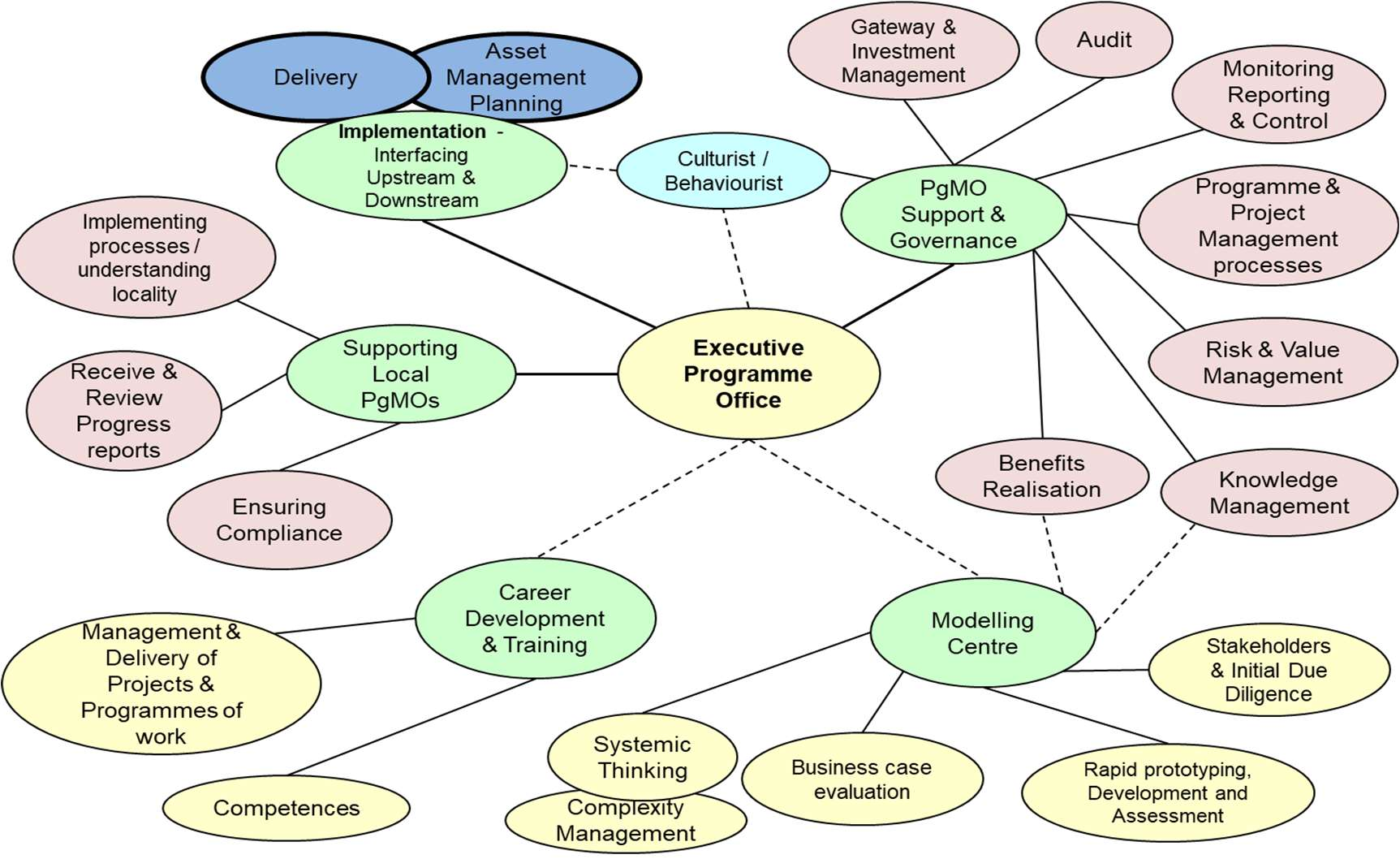

Figure 5 below presents a fully integrated EPO with the local PMOs and overseeing the whole monitoring and control processes as well as other functions. For example, overseeing:

  • Governance, audit, and assurance functions
  • Delivery and project control
  • Modelling and career development
  • A central hub linking multiple local PMOs
Figure 5. A sample EPO for an international organisation.
Figure 5. A sample EPO for an international organisation.

Technological Synergy: The Digital PMO

Modern project delivery requires the linking of Project, Programme and Portfolio Management (P3M) delivery and Strategic Management through ERP software. The PMO could be the department that undertakes the overall responsibility for the maintenance and implementation of the software tools that support Governance decision-making for P3M.

ERP and Project Management Information Systems (PMIS) Integration

One of the biggest advantages of a PMO is the reduction of duplication through system automation. PMOs often define or manage enterprise-level systems (ERP, project control tools, reporting platforms, etc.). By integrating project control software tools with financial ERP systems, data entered at the project level can automatically update corporate-level finance and resource modules, establishing a Bottom-Up rolling of data. The software setup, through the standard structures and coding, should also enable the Top-to-Bottom flow of data.

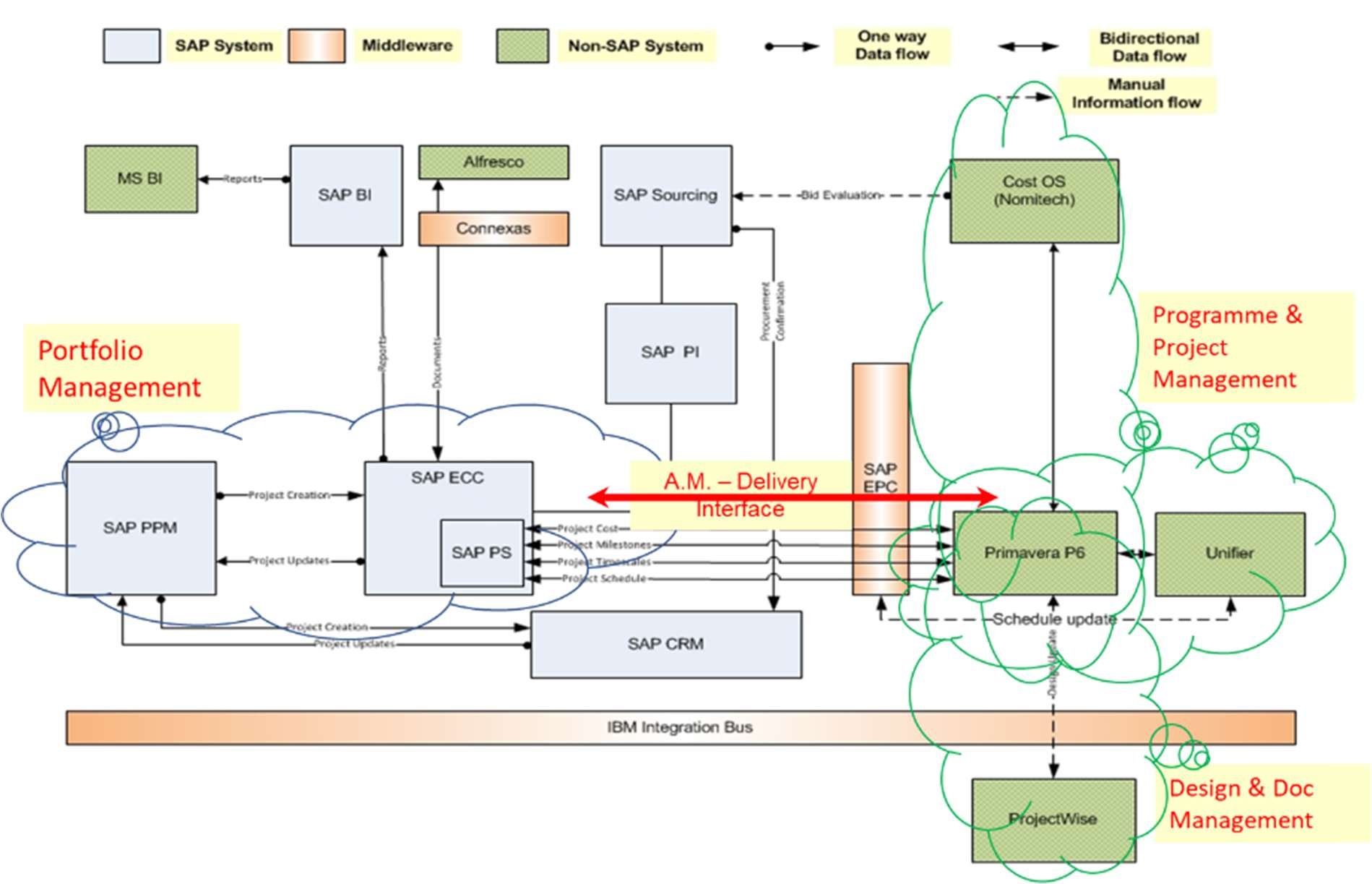

Figure 6 below demonstrates how the various software tools are integrated to support Asset Management and Delivery. The author contributed to the rolling out of the system depicted in this figure whilst working for a major utilities organisation.

Figure 6. Integration of software tools – ERP and Project Management, supporting P3 delivery.
Figure 6. Integration of software tools – ERP and Project Management, supporting P3 delivery.

The Rise of Artificial Intelligence (AI) and Machine Learning (ML)

With the advent of technologies, the future of the PMO-PC relationship lies in becoming an even more data-driven one. AI technologies, such as predictive analytics and Robotic Process Automation (RPA), are transforming the PMO role.

RPA
Automates repetitive, labour-intensive tasks such as moving data between systems, allowing PMO staff to focus on high-value coaching and mentoring.
Machine Learning
Uses historical data to make correlations and calculate predictions. However, the PMO must manage risks like "Underfitting" (insufficient data) or "Overfitting" (distorting accuracy with outliers).
Generative AI
Tools like ChatGPT are now being piloted for WBS generation and sequencing maintenance activities.
Agentic AI
Shifting AI from passive assistance to autonomous action. AI agents acting independently, or as a team of agents, which undertake a high-level goal, break it down into steps, use tools, and work towards the set objective with minimal human supervision.

In this digital era, the PMO takes on the role of 'Data Hunter, Data Gatherer, and Data Farmer', serving as the ethical custodian of the organisation's project data lake and providing (through the PC) the human in the loop.

Conclusion

The PMO – Project Control relationship is both structural and cooperative. PMOs shape the governance, processes, behaviours, and systems necessary for organisational consistency and strategic execution. Project Control enables the PMO to perform these functions by providing the analytical foundation upon which decisions, assurance, and improvements are made.

A high-performing organisation is one in which both areas:

  • Maintain clear interfaces
  • Share structures, tools, and methodologies
  • Operate with consistent data standards
  • Collaborate through integrated governance

PMOs fail when context, interfaces, and behaviours are not addressed, areas in which Project Control can provide stabilising influence. Conversely, Project Control fails without the PMO's oversight, governance, and systems support. The optimal relationship is therefore one of mutual reinforcement. The latest technologies will enable and will require a much closer integration between PMO-PC and therefore, organisations will need to consider carefully the type of PMO to be set up as well as the departments that will be included within it.

Reflective Questions
Does your PMO provide the standard structures (WBS/CBS) required for Project Control to report consistently across different departments?
Are the project management standard structures (WBS, CBS, OBS, RBS, etc.) consistently applied across all programmes and portfolios?
Is your Project Control data logically linked to provide a true picture of performance, or are we still reporting in 'silos'?
Are Project Control tools integrated with enterprise systems (ERP, financial systems, BI tools), and how effectively is this done?
Does your PMO ensure data quality, integrity, and standardisation across all reporting levels?
Is your PMO operating at the "Partnership" or "Innovation" level of the hierarchy, or is it still struggling to solve a basic "Business Problem"?
Are you utilising the PMO as a Centre of Excellence to capture lessons learned and drive continuous improvement?
Does your PMO clearly define how Project Control integrates into governance and assurance processes?
How well does your organisation manage interfaces between Project Control, PMO, and other directorates?
What cultural or behavioural challenges limit the PMO – Project Control relationship in your environment?

References

Al-Maghraby, R. (2011). 'How to establish a Project Management Office (PMO)', PM World Today, 13(5).
Antoniadis, D. (2018). Demystifying Project Control. Amazon.
APM (2004). APM Directing Change. A guide to governance of project management. Princess Risborough.
APM (2006). APM Knowledge Guide: Introduction to Project Control. Princess Risborough.
APM (2015). APM Planning, Scheduling, Monitoring and Control Guide. Princess Risborough.
APM (2019). APM Body of Knowledge (7th ed.). Princess Risborough.
Arnaz-Pemberton, E.-R. (n.d.) The PMO Hierarchy of Needs. Available at: https://www.futurepmo.com/pmo-hierarchy-of-needs/
Boudreau, P. (2010). How the Project Management Office can use Artificial Intelligence to Improve the Bottom Line.
Giraudo, L. and Monaldi, E. (2015). PMO evolution: from the origin to the future. London: PMI.
Hobbs, B. & Aubry, M. (2007). 'A multi-phase research program investigating Project Management Offices (PMOs): The results of phase 1', Project Management Journal, 38(1), pp. 74–86.
Jordan, A. (2020). 'Now More Than Ever, You Need Your PMO', ProjectManagement.com. Available at: https://www.projectmanagement.com/articles/624363/Now-More-Than-Ever--You-Need-Your-PMO
Jordan, A. (2023). 'Where Should the PMO Focus?', ProjectManagement.com. Available at: https://www.projectmanagement.com/articles/863886/Where-Should-the-PMO-Focus
OGC (2008). P3O: Portfolio, Programme and Project Offices.
PMI (2017). A Guide to the Project Management Body of Knowledge (6th ed.).
PMO Flashmob (2020). Inside PMO: The AI PMO: Threat or Opportunity?
Salameh, H. (2014). 'A Framework to Establish a Project Management Office', European Journal of Business and Management, 6(9).
Salamah, H. and Alnaji, L. (n.d.). Challenges in Establishing, Managing, and Operating a Project Management Office.
Van der Linde, J. and Steyn, H. (2016). 'The effect of a project management office on project and organisational performance', South African Journal of Industrial Engineering, 27(1).
DA
Dr. Dimitris N. Antoniadis
London, UK

Dr Dimitris N. Antoniadis PhD MSc BEng(1st) CEng FAPM FCMI MIMechE, based in UK, has 35+ years' experience in Programme and Project Management positions, having covered project phases from concept to handover and operation / maintenance.

He is currently Director in the Programme, Project Management and PMO with DANTON PROGM, technical advisor to Novacept and has set up the BSc in Project Control that is currently delivered by the partnership between London Metropolitan College and the University of West London.

He has held Senior Management posts in major utilities, infrastructure and construction organisations delivering programmes of works ranging from £250M to £3.2Bn. As Head of Programme Management Office (PMO) he has set up and run the departments within challenging partnering environments, setting up all the processes from governance to reporting. He has also led / co-led major business transformation programmes for Client organisations in UK and abroad, integrating project management software tools with ERP systems.

He is the author of the book Demystifying Project Control; contributed chapters in books on complexity, leadership and other project management topics and has written a number of journal and conference papers. He has been a guest speaker at UK Universities as well as International conferences on various project management topics.

He was awarded the PhD, from Loughborough University, UK, on the subject of Managing Complexity in Project Teams, where he developed a framework for managing the effects of complexity on projects.

How to cite: Antoniadis, D. (2026). The Symbiotic Relationship Between the Programme Management Office (PMO) and Project Control; PM World Journal, Vol. XV, Issue V, May.
