Australia

In this article, the author introduces a transformative approach to risk management by integrating temporal dynamics into the established three-dimensional (3D) risk matrix. Traditional two-dimensional (2D) models, which assess risks based on likelihood and impact, fail to capture the complexity and urgency inherent in modern projects. Building on the 3D Risk Matrix, where risks are positioned within a cube defined by likelihood, impact on time, and impact on cost, the proposed approach reconceptualises risks as dynamic vectors rather than static points.
This shift enables the incorporation of Risk Velocity, a critical and unexplored dimension that measures the speed at which risks materialise and escalate. The author expands on two distinct components of risk velocity, defined as Lead Time Velocity (LTV), representing the approach of a risk toward occurrence, and Impact Time Velocity (ITV), describing the rate at which consequences intensify post-occurrence. By applying vector mathematics, the proposed approach captures both magnitude and direction, offering a richer representation of risk severity and trajectory.
In an era characterised by increasing project complexity and interdependence, the demand for more improved and dynamic risk management methodologies has never been greater. Traditional approaches, while foundational, often fall short in capturing the full, multi-dimensional nature of modern risks. This paper builds upon established risk theory to propose a novel, vector-based framework that integrates the critical dimension of time. By reconceptualising risks as dynamic vectors rather than static points, we can achieve a more nuanced understanding of not only their potential impact but also the speed at which they approach and escalate.
The core practice of risk management is rooted in understanding and addressing uncertainty. The Association for Project Management (APM) Body of Knowledge (2019) provides a concise and powerful definition of risk: "The potential of an action or event to impact the achievement of objectives."
The traditional risk management process operates as a dynamic, cyclical flow, ensuring that risk analysis remains current as new knowledge emerges. This process involves several key stages (APM, 2019):
At the heart of this process lies a fundamental dichotomy in how risks are managed. Likelihood is managed through the implementation of robust governance and control mechanisms. Impact is managed through the execution of specific mitigating actions designed to lessen its severity.
Accuracy in visualising and assessing complex risks is a supporting and valuable mechanism for any project team. However, conventional two-dimensional (2D) methodologies have faced growing criticism for their inability to capture the multifaceted nature of modern project threats.
Key criticisms include:

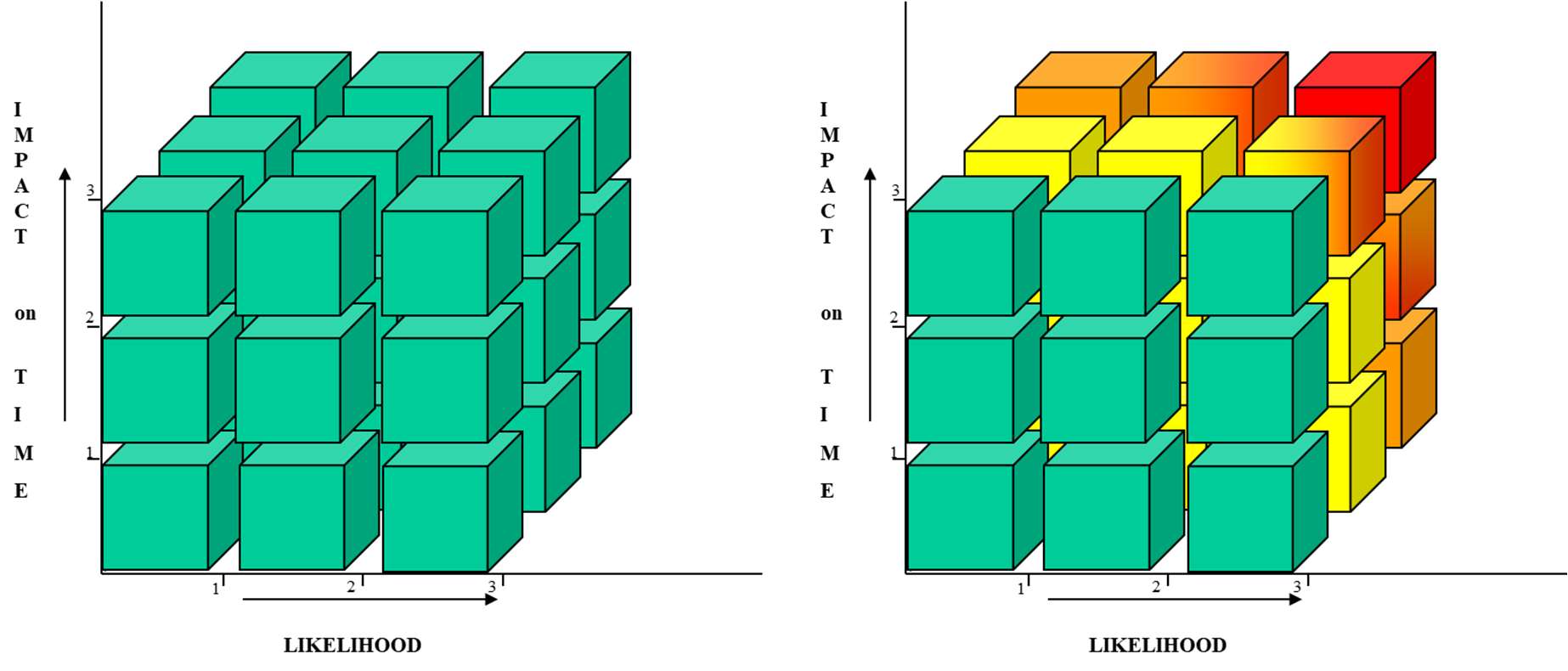

To overcome these issues, the 3D Risk Matrix was developed (Antoniadis & Thorpe, 2003). The proposed model expanded the traditional framework by positioning risks within a three-dimensional space defined by three basic axes: Likelihood (L) in the 'x' direction, Impact on Time (IoT) in the 'y' direction, and Impact on Cost (IoC) in the 'z' direction.

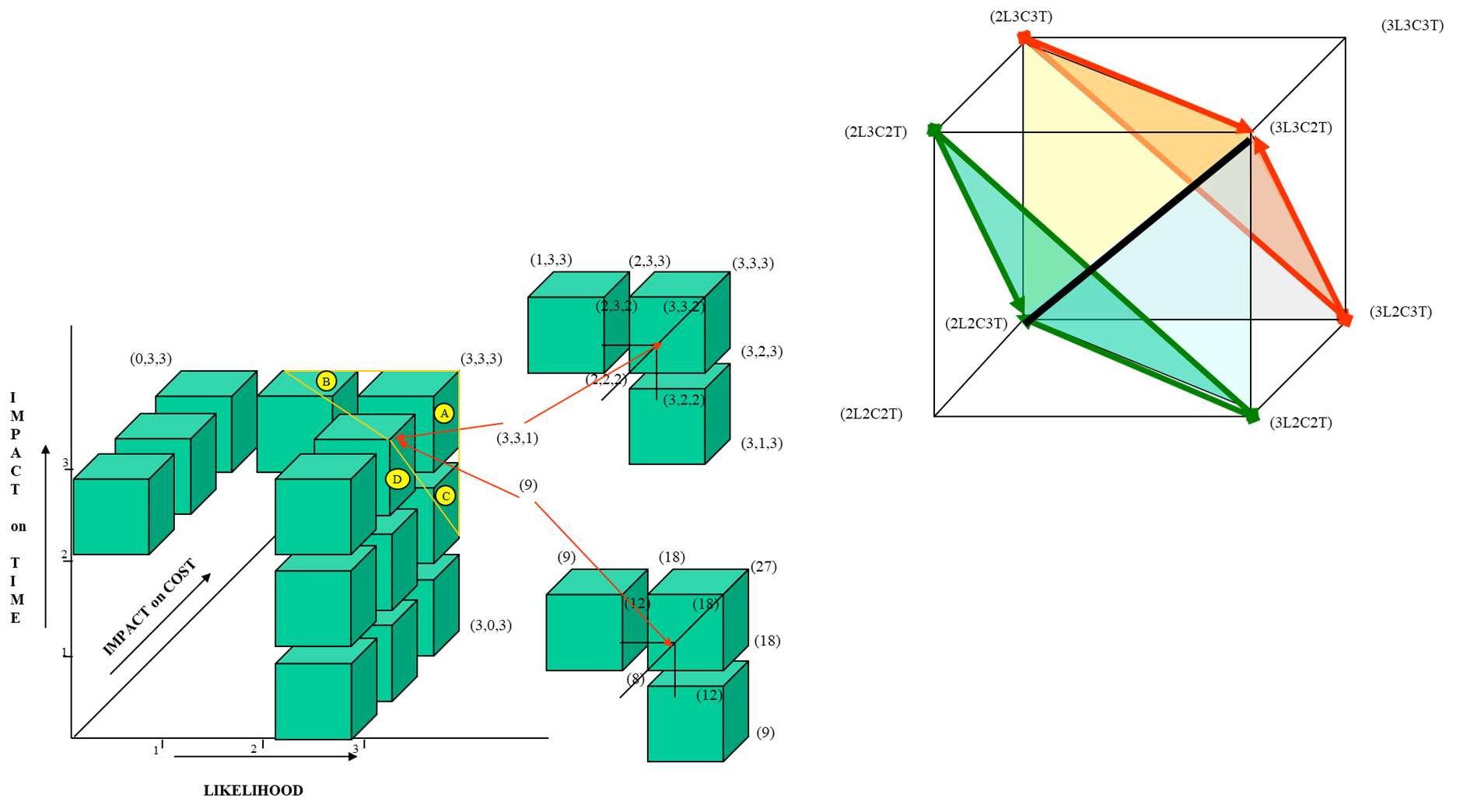

As described in Antoniadis & Thorpe (2003), a core innovation of this methodology is the concept of "Risk Pyramids." Rather than treating risks as isolated points, the model recognises that they can exist in the space between the integer coordinates. Pyramids are formed by connecting adjacent coordinates within the main cube, creating discrete zones of risk priority.

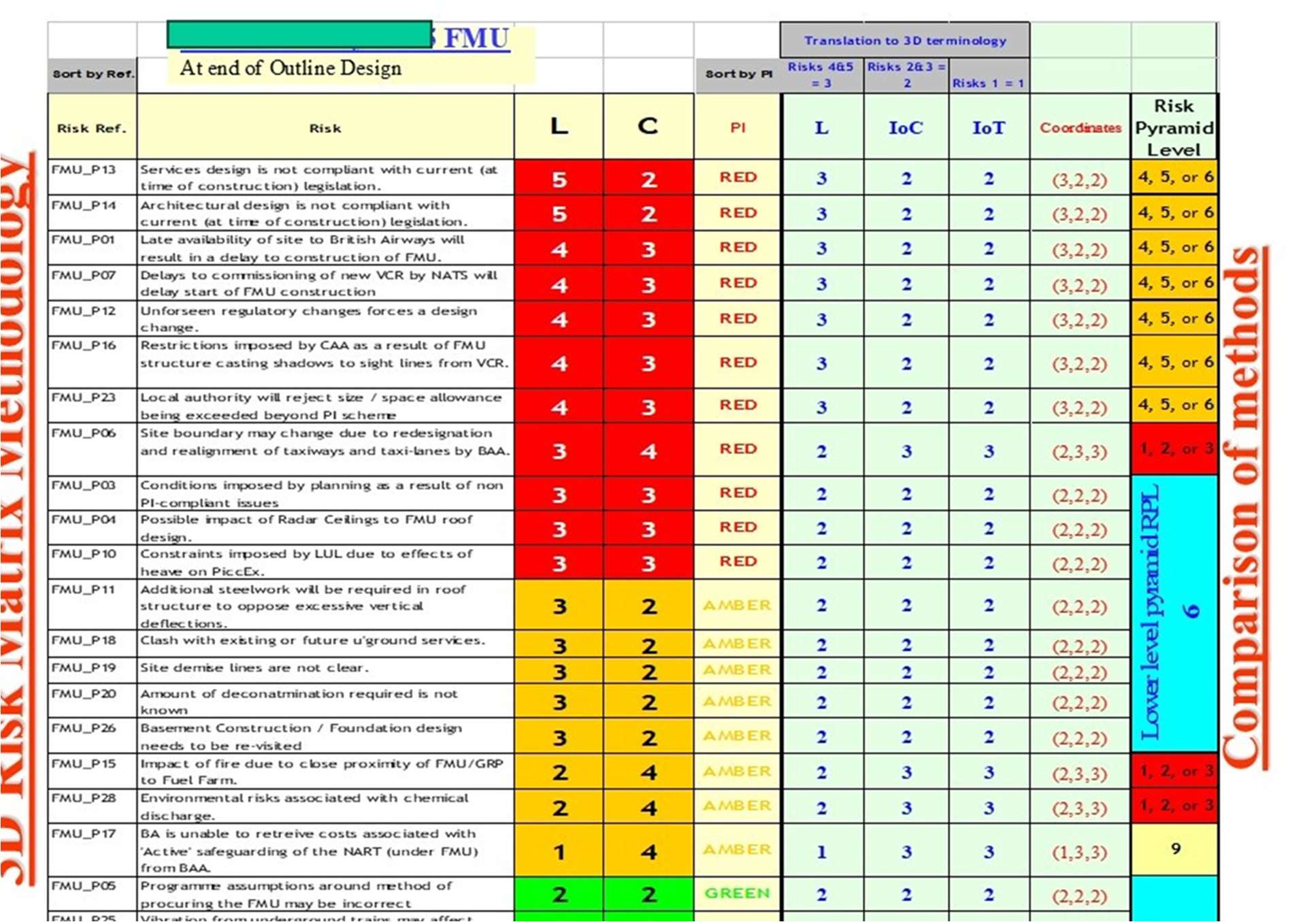

At the ISEC-02 Conference in 2003, the author presented a case study of applying the 3D Risk Matrix (3DRM) methodology on an airport Fuel Management Unit.
To manage risk proactively, it is not adequate to understand if a risk might occur and what its impact might be. The team and the PM need to understand the speed at which it can affect a project. The concept of Risk Velocity provides this essential temporal dimension, transforming risk analysis from a static snapshot into a dynamic forecast.
This concept can be deconstructed into two distinct and equally important components:
In this section the author will synthesise the spatial awareness of the 3D Risk Matrix with the temporal dynamics of Risk Velocity. By moving beyond a conception of risks as static coordinates, we can reimagine them as vectors, mathematical objects which possess both magnitude and direction.

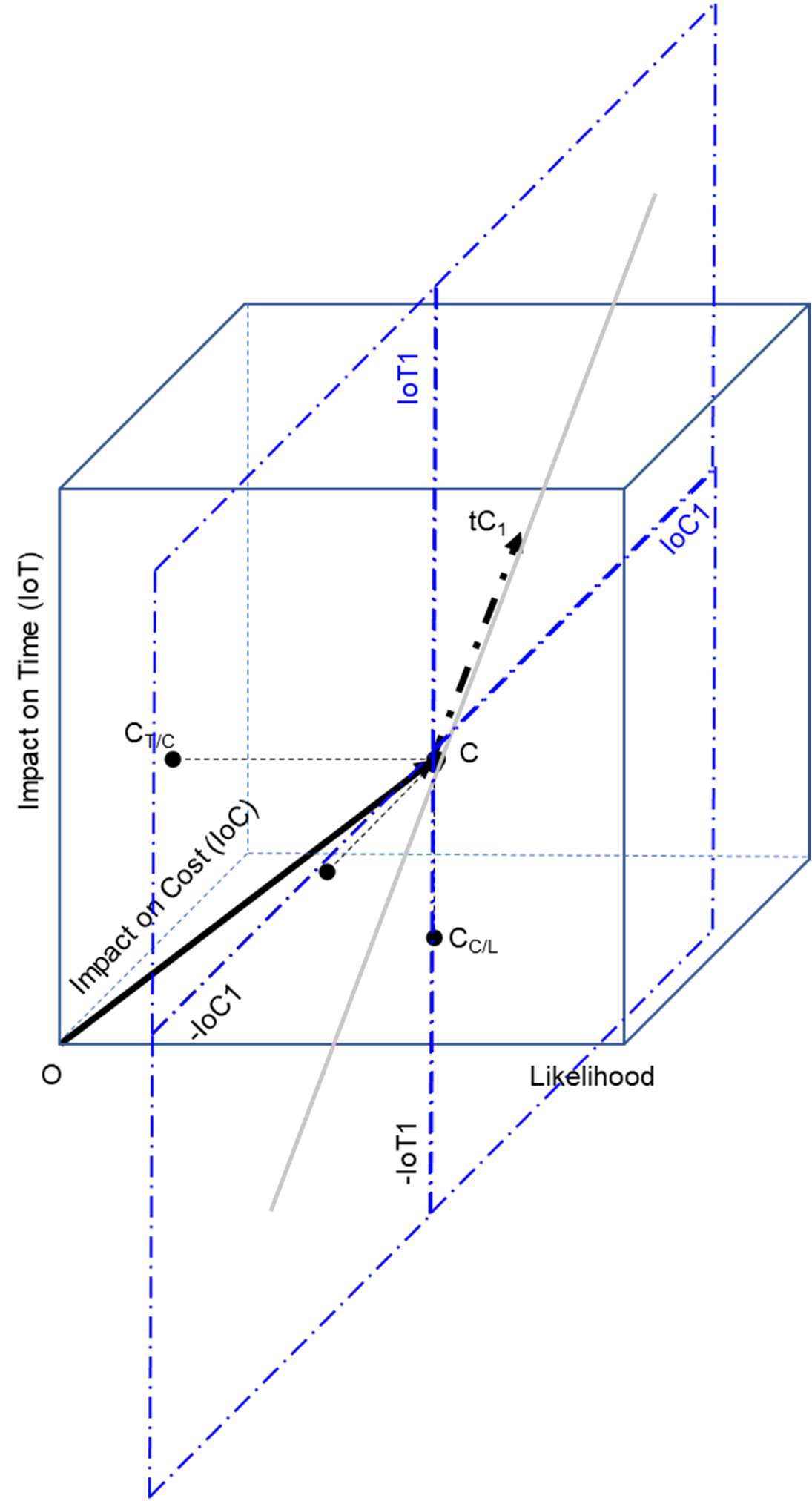

The author proposes that a risk located at coordinates (L, IoT, IoC) within the 3D cube can be represented as a position vector. This vector originates from the point of zero risk, <0, 0, 0>, and terminates at the risk's coordinates. For example, for a risk with L=2, IoT=3 and IoC=3, the risk will terminate at point C and have coordinates <2,3,3>. This primary vector, which we will call OC, represents the path the risk takes as it materialises.
To operationalise the vector-based risk model, a foundational understanding of vector mathematics is essential. The general formula for the vector equation of a line in 3D space is:

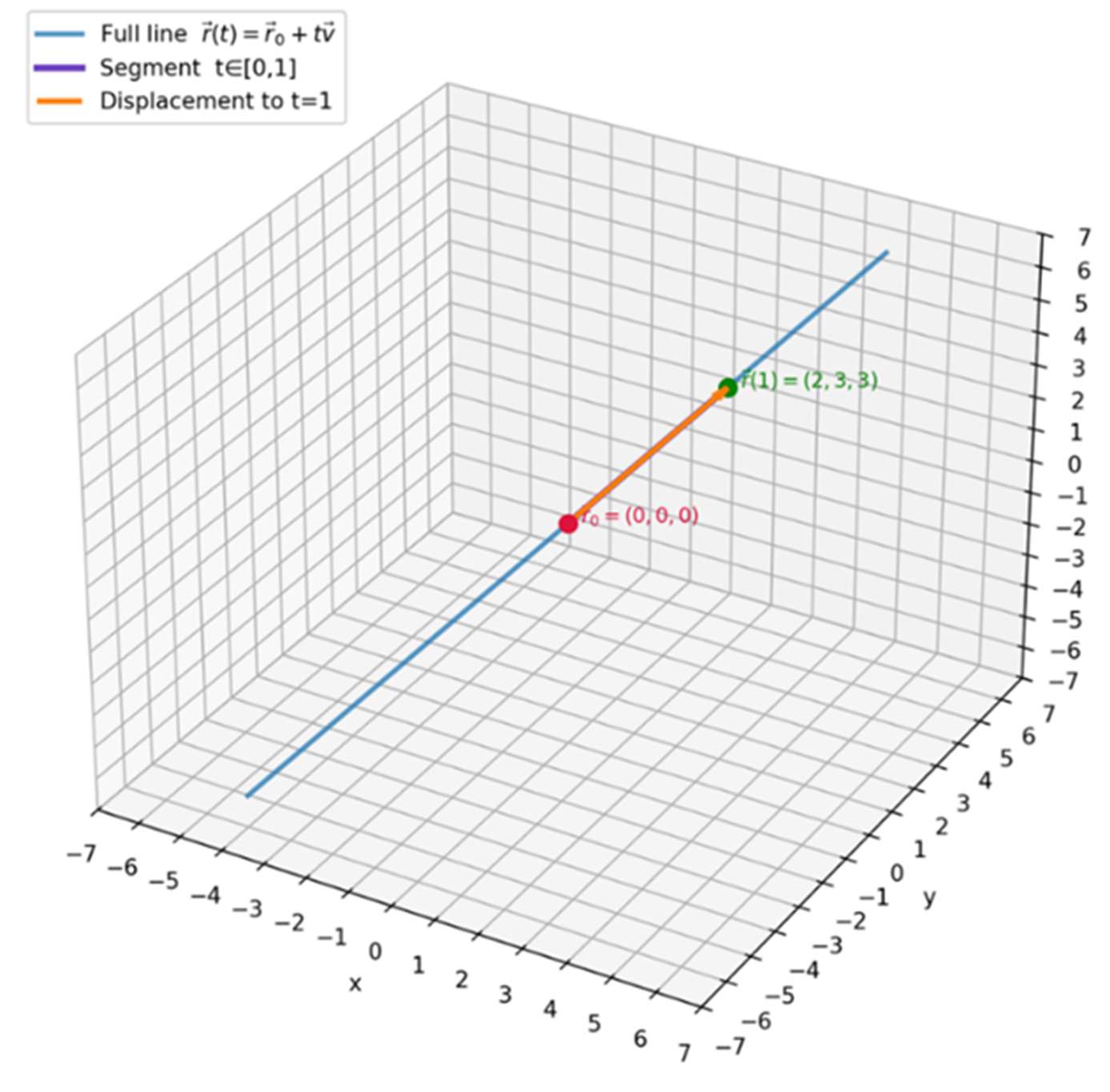

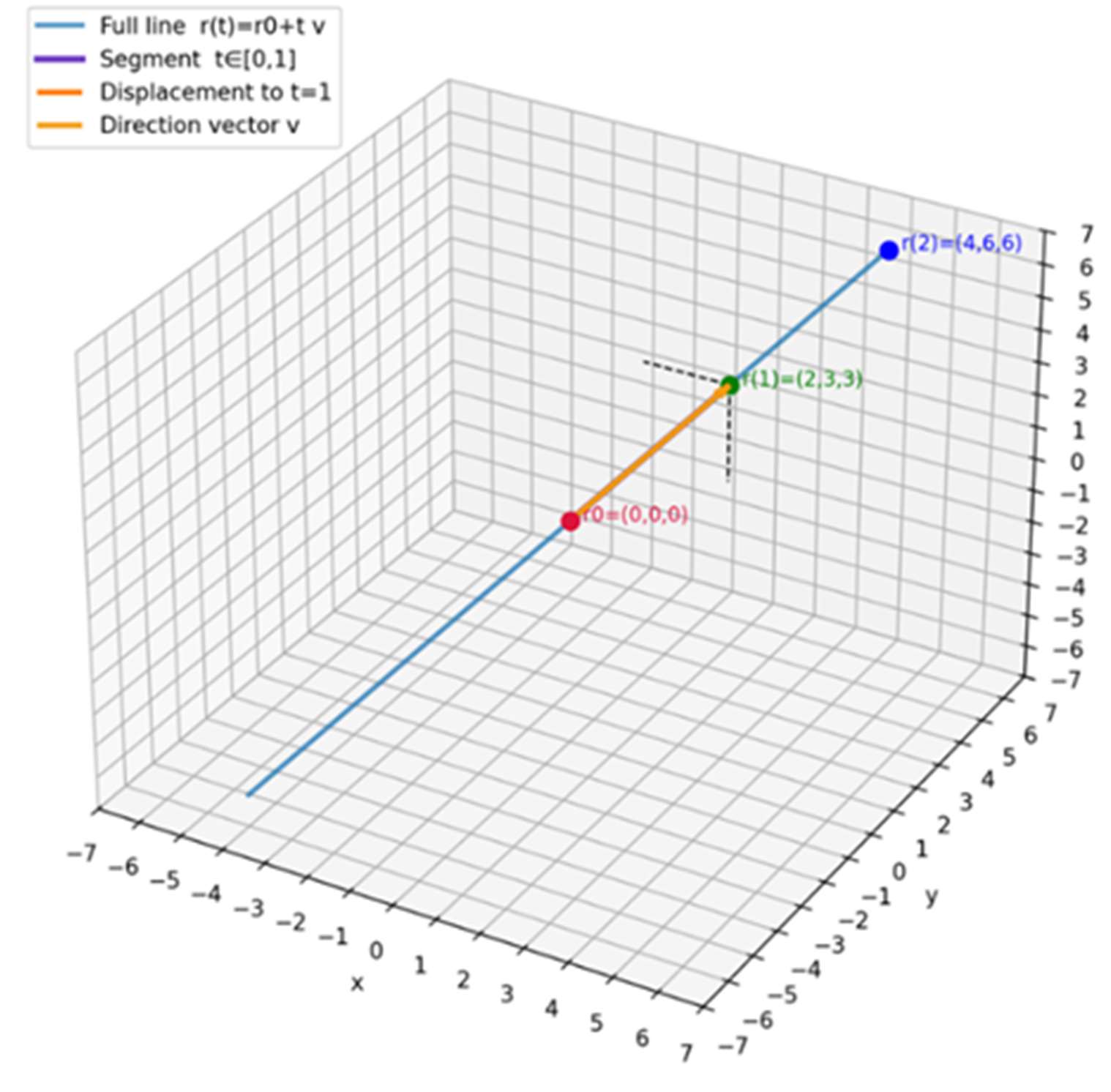

r(t) = r0 + t * v
Each component of this equation has a specific meaning:
The pivotal argument for applying this to risk management lies in the interpretation of the parameter 't'. In pure mathematics, 't' is merely a scalar. However, in physics/kinematics as also in the context of project management, which operates entirely within the dimension of time, 't' is not just a scalar but should be interpreted as a time variable, measured in units such as hours, days, or weeks.
This section represents the culmination of the preceding concepts, formally defining a complete, dynamic risk model. This framework is comprised of two key vectors that together capture the temporal journey of a threat: the Lead Time Velocity (LTV) vector, which describes its path to occurrence, and the Impact Time Velocity (ITV) vector, which models the escalation of its consequences.

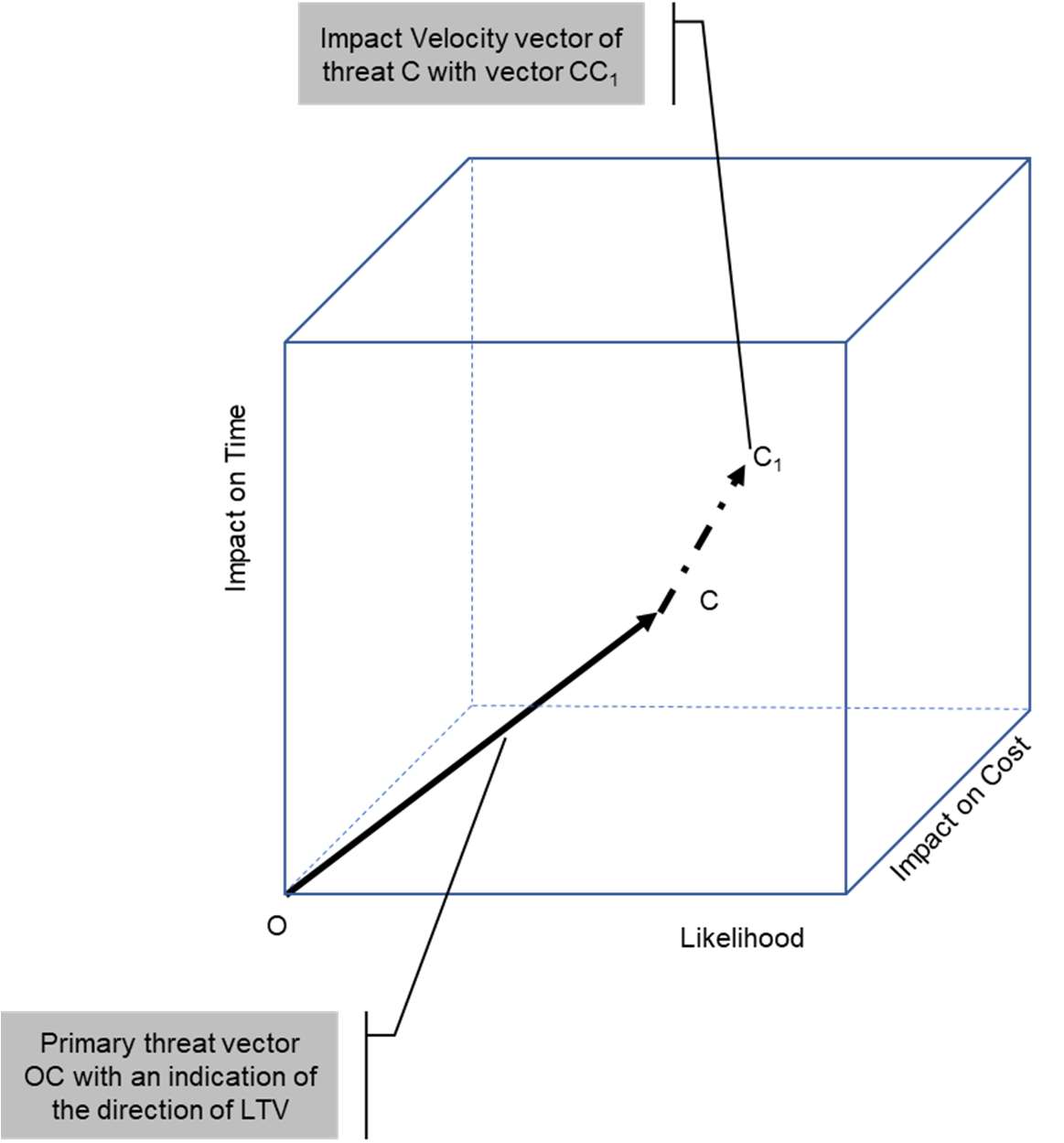

The Lead Time Velocity (LTV) is represented by the primary threat vector OC. This vector originates at the point of zero risk, <0, 0, 0>, and terminates at the coordinates of the identified risk C = (L, IoT, IoC) within the 3D cube. Its magnitude indicates the overall severity, while its direction reveals the nature of the impending impact.

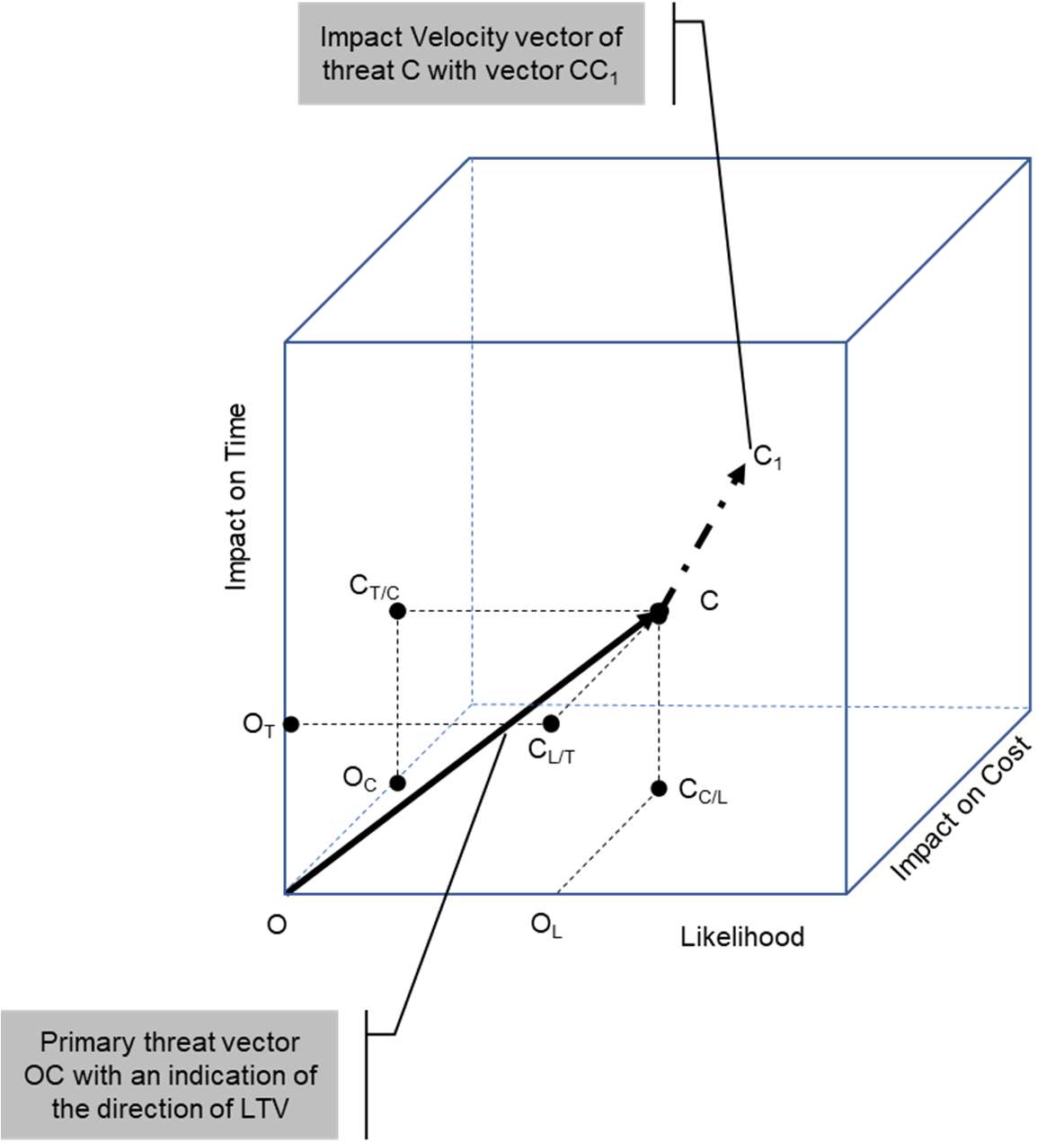

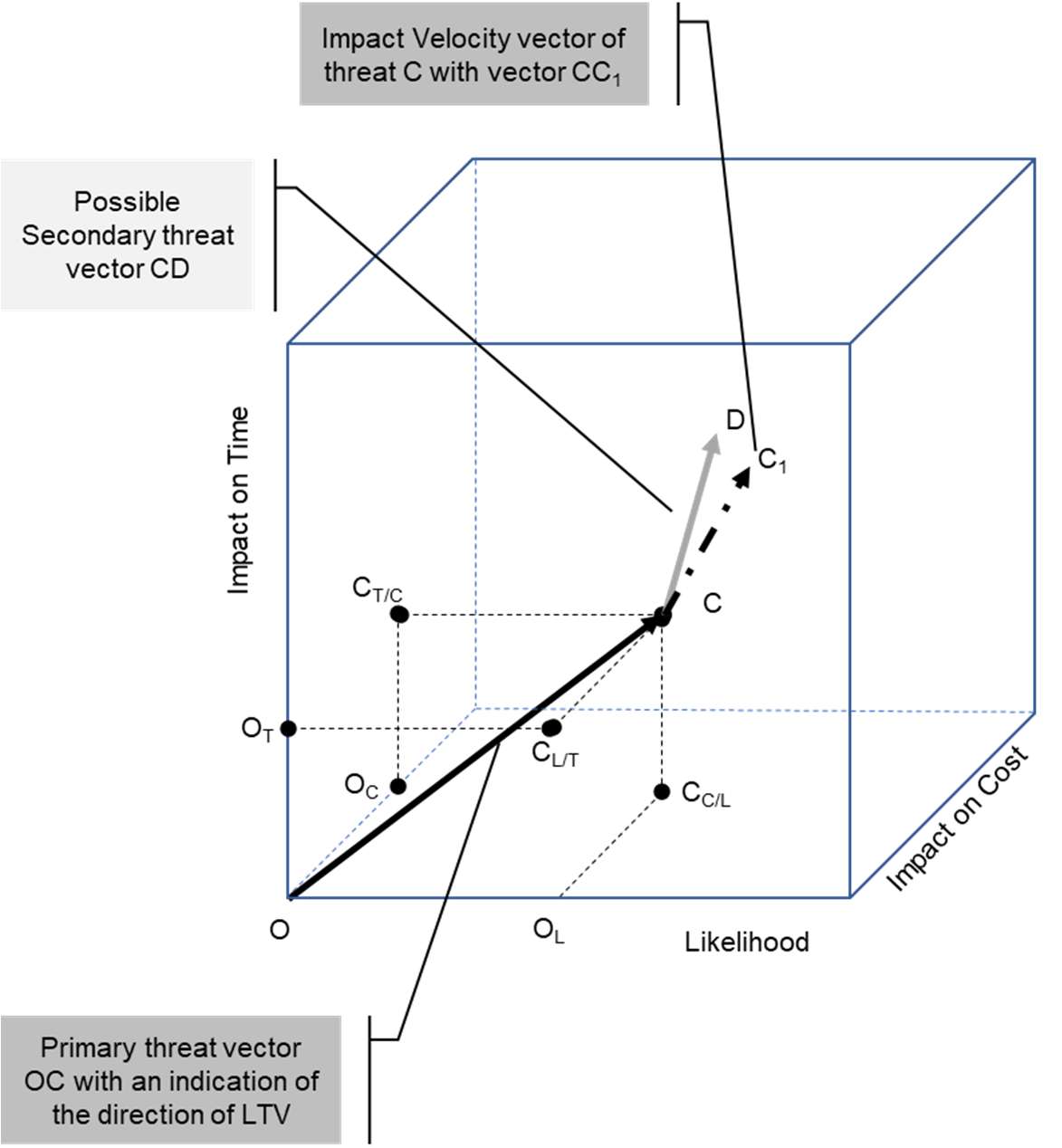

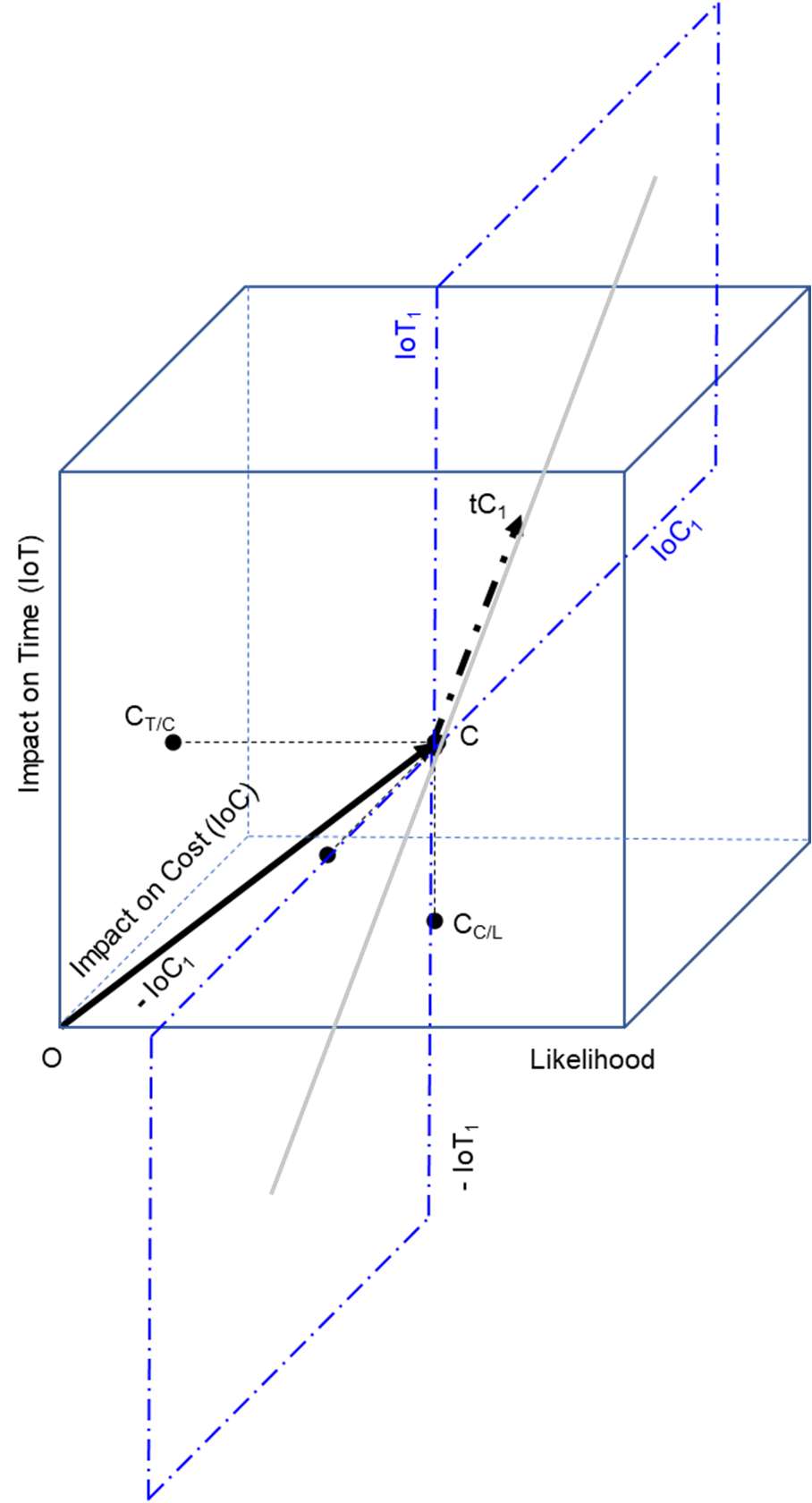

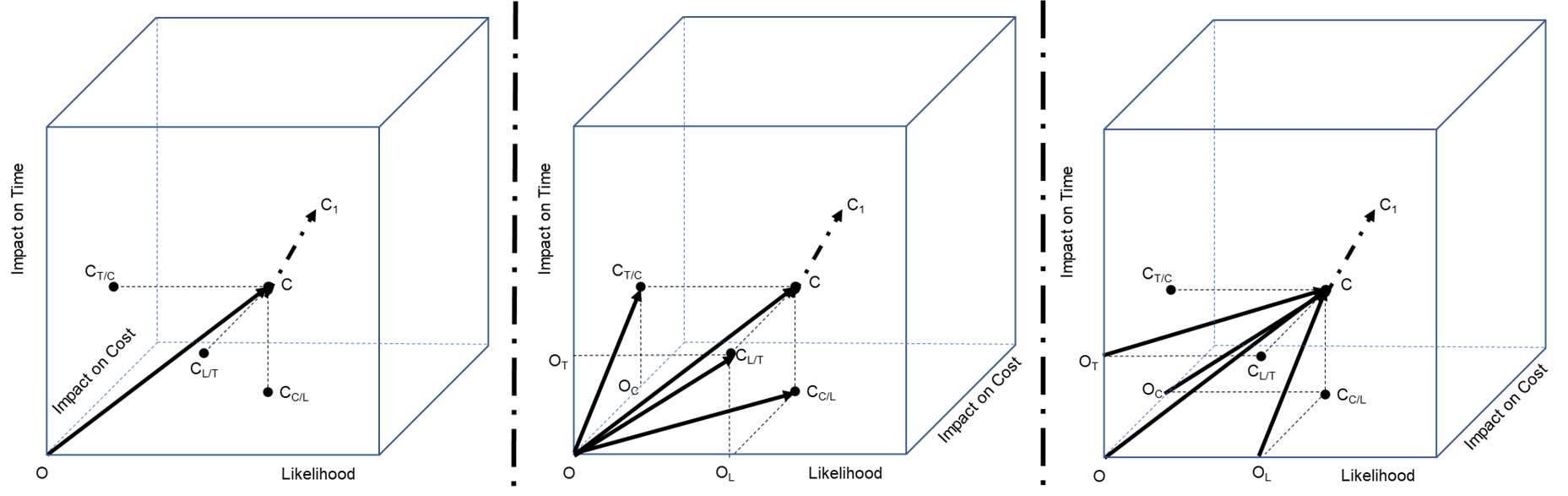

Once a risk event occurs at point C, its likelihood is no longer a variable; it has happened. At this moment, a second velocity becomes critical: the Impact Time Velocity (ITV). The ITV is represented by the secondary vector CC1, whose origin is at point C, the endpoint of the LTV vector. Two potential models are proposed for how this ITV vector operates:

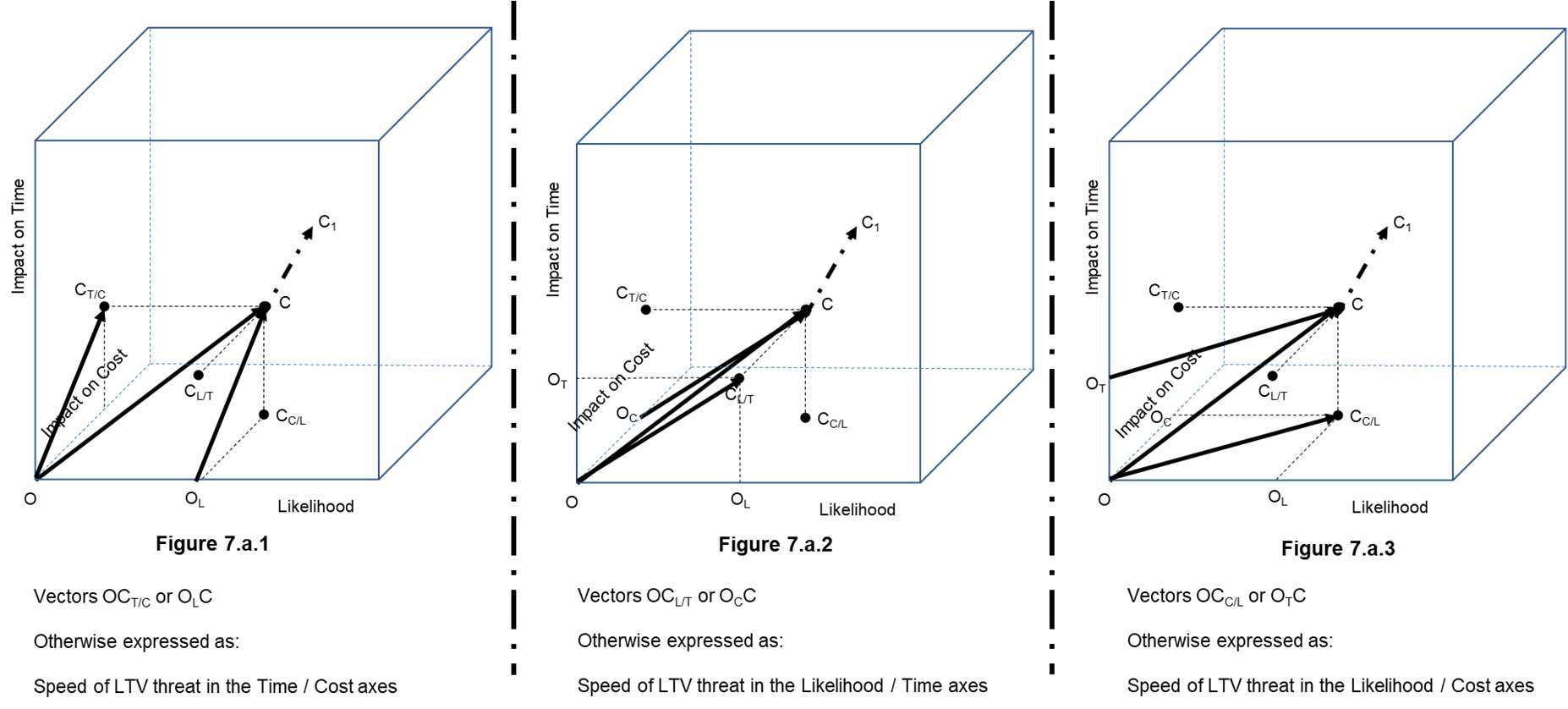

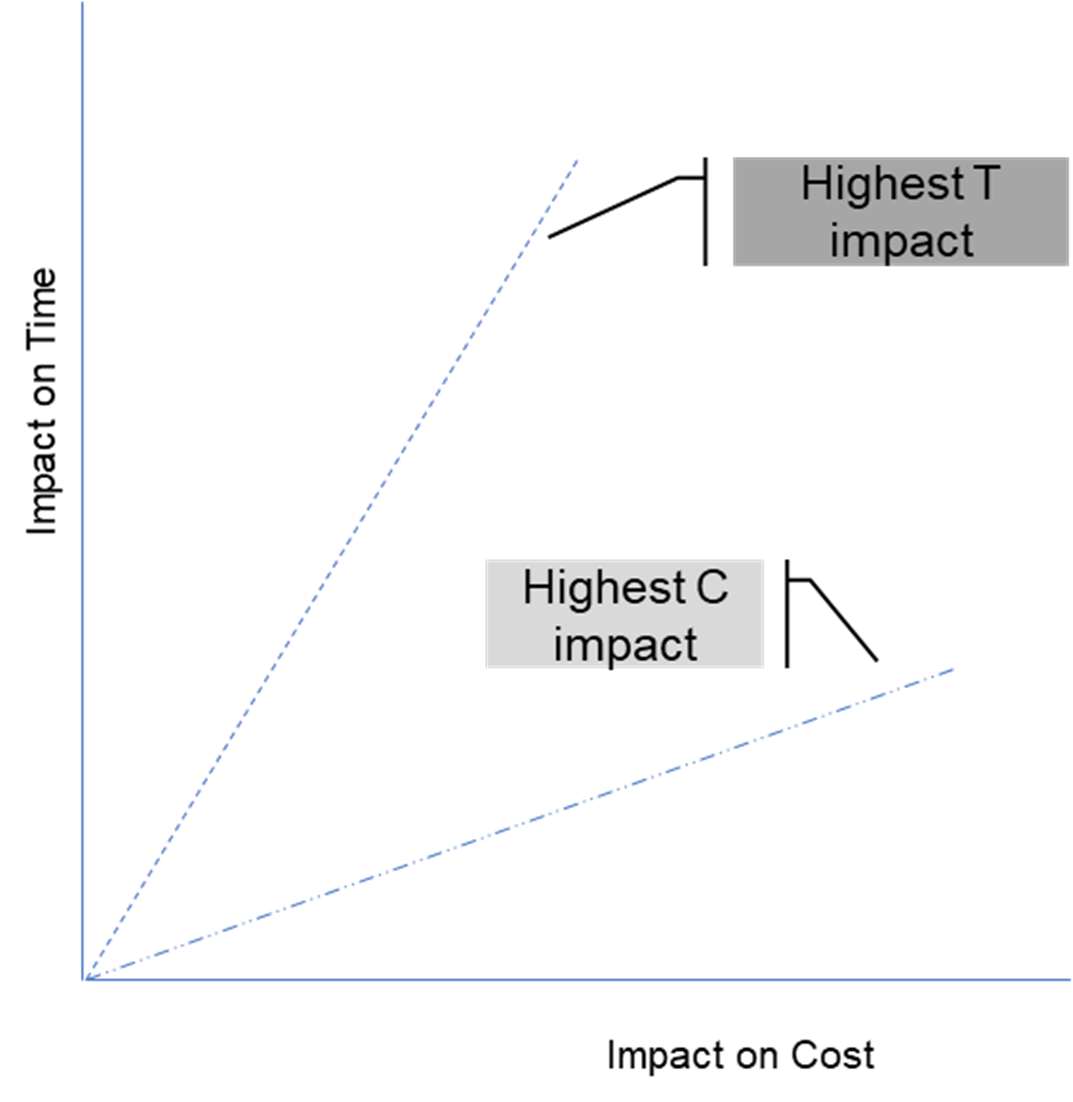

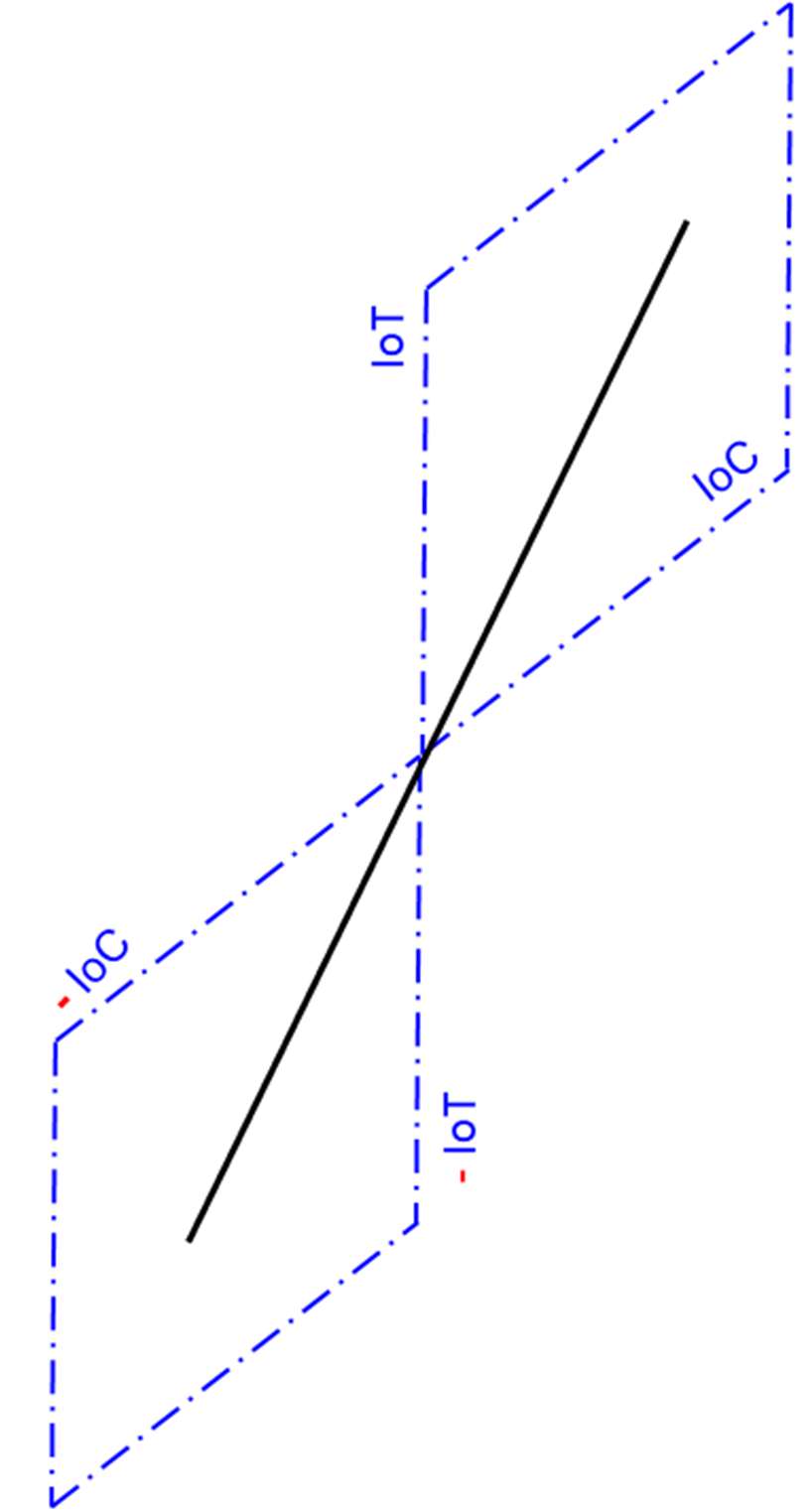

A 2D Plane Model: In this model, the ITV vector acts exclusively on the 2D plane defined by the Impact on Time (IoT) and Impact on Cost (IoC) axes. Since the likelihood is fixed at 100%, the velocity of the consequences is a function of only time and cost impacts.

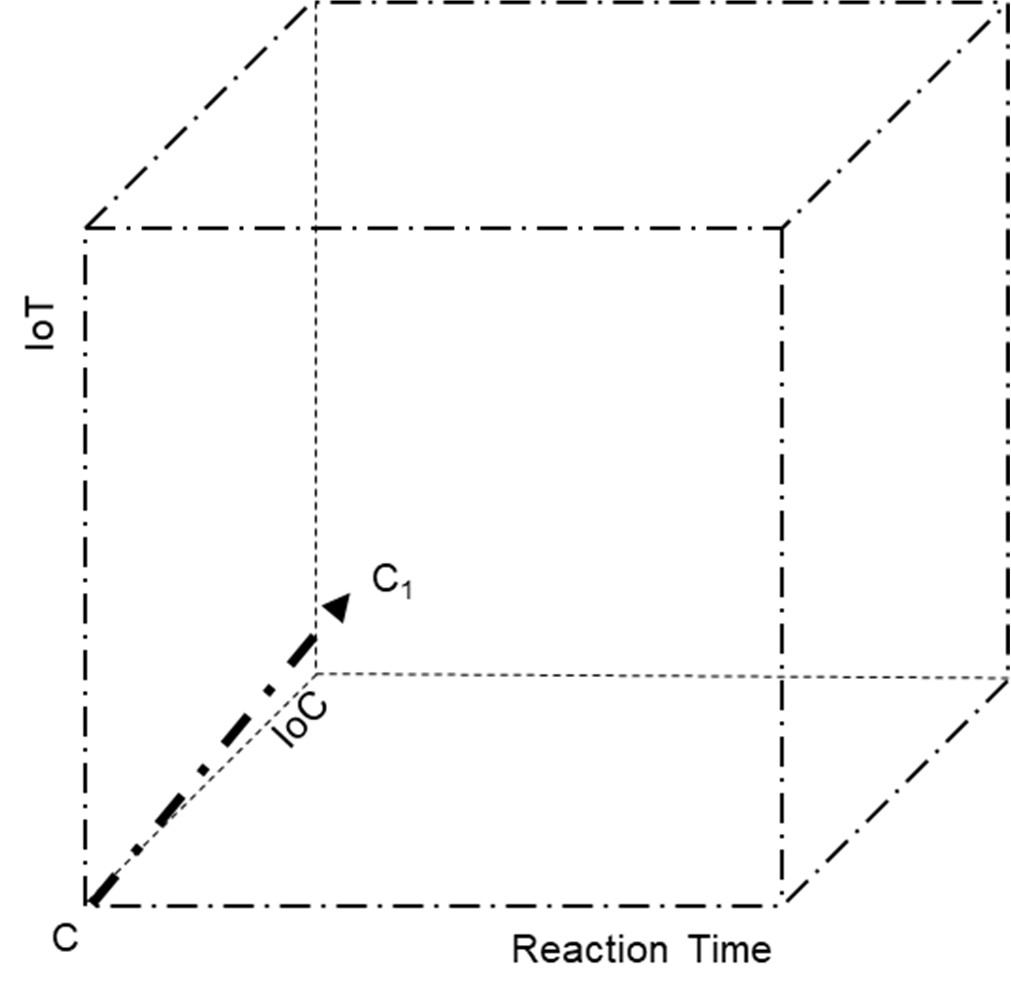

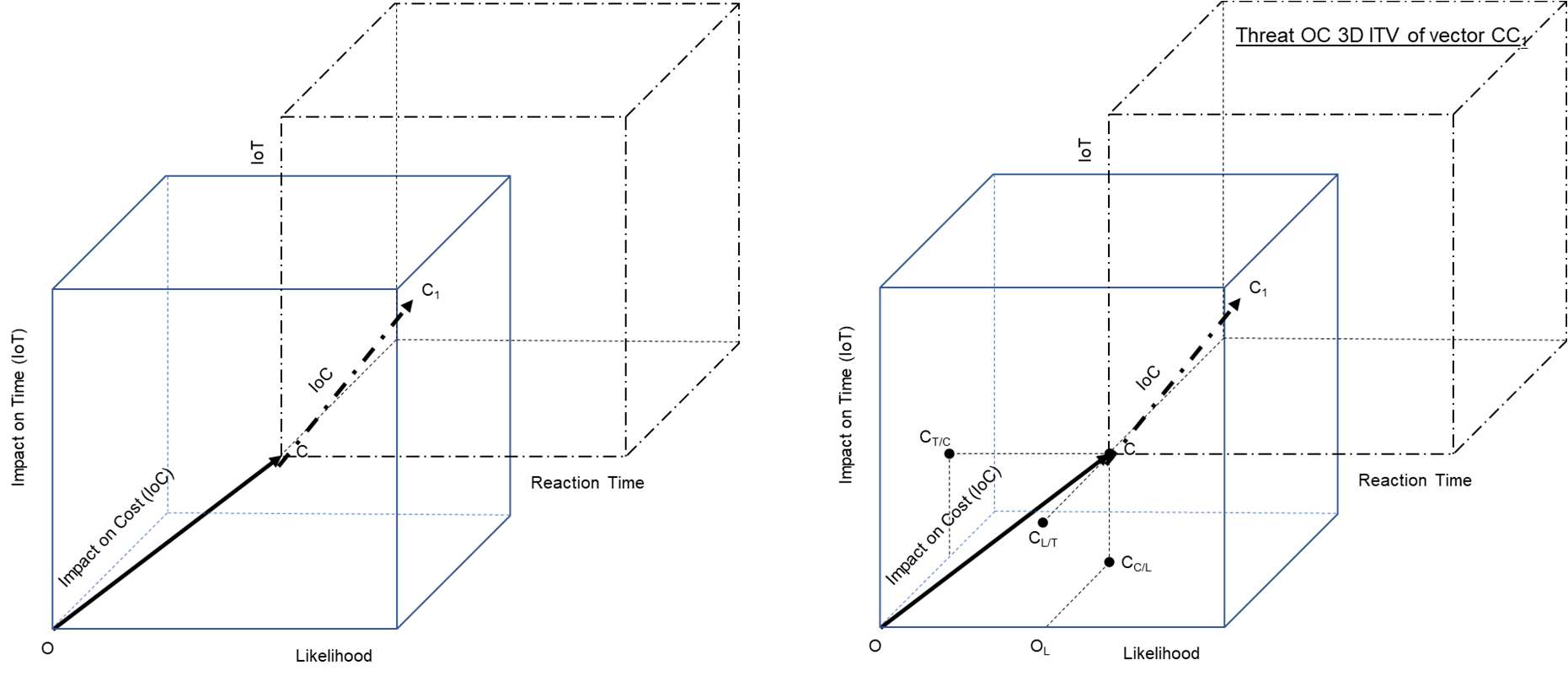

A 3D Space Model: An alternative and more sophisticated model introduces a new third axis: "Reaction Time." After a risk occurs at point C, the ITV vector operates in a new 3D space defined by IoT, IoC, and Reaction Time. This model is powerful because it quantifies the project team's response capability as a third dimension of the impact, modelling how delays in reaction can exacerbate cost and time consequences.
The author has attempted to present a fundamental evolution in risk assessment, arguing for a shift from a static, point-based methodology to a dynamic, vector-based model. By incorporating the temporal dimensions of Lead Time Velocity (LTV) and Impact Time Velocity (ITV) into a three-dimensional risk space, organisations can gain unprecedented insight into the true nature of threats.
The primary advantages of adopting this 3D vector-based methodology are transformative, offering greater clarity, proactivity, and analytical rigour. Avenues for future work include:
Ultimately, by embracing the mathematics of vectors and the physics of velocity, this methodology has the potential to transform risk management. It can elevate the practice from a reactive, compliance-driven exercise into a truly predictive and strategic discipline, empowering project leaders to navigate uncertainty with greater foresight and confidence.
